EXECUTIVE PAPER

Beautiful Is Not a Business Case

Concept viability tests whether the brand promise survives customer, commercial, site, regulatory, operational, delivery and whole-life reality.

7 min read ·
Seven-case model testing customer, commercial, site, regulatory, operational, delivery and whole-life viability.

EXECUTIVE SUMMARY

An attractive concept is not yet a responsible investment case. It becomes viable only when its essential promise survives customer behaviour, economics, site conditions, regulation, operations, delivery and whole-life performance without relying on invisible heroics.

This paper introduces a seven-case viability test for premium retail and hospitality concepts. It helps leaders identify contradictions early, distinguish feasibility from value and decide whether to proceed, adapt, pilot, pause or stop before commitment makes failure expensive.

KEY TAKEAWAYS

  • 01
    Feasibility asks whether something can be delivered; viability asks whether it remains worth delivering.
  • 02
    Customer, commercial, site, regulatory, operational, delivery and whole-life cases must support the same proposition.
  • 03
    Real environmental and operating conditions should be tested before design preferences become commitments.
  • 04
    Adapt, pilot, pause and stop are legitimate outcomes of responsible concept development.

How premium concepts earn the right to be implemented

A FAMILIAR SITUATION

The concept everyone wants to protect

The hero image has done its work. Leadership can see the future environment: the arrival, the material character, the service choreography, the moment customers will photograph. The concept has become emotionally real before it is operationally real.

Questions now arrive as threats to coherence. Can the team replenish the display during trading hours? Will the proposed material age consistently? Does the space work for customers who do not follow the expected journey? Can the service model survive an ordinary busy day? Each question is sent to a specialist to solve without changing the idea.

This is how an attractive concept becomes an expensive obligation. The organisation protects the image while site, cost, operation and delivery are asked to absorb its contradictions.

Feasible is not the same as viable

A buildability review asks whether an environment can be made. A cost plan estimates what it may cost. A programme tests whether activities fit a date. A code review tests compliance. Each is necessary. None answers whether the concept remains worth implementing when the full system becomes visible.

Viability asks a larger executive question: should we commit to this concept, in this place, through this operating and delivery model, at this level of risk - and what must be true before we do?

The distinction is important because almost anything can be made technically possible with enough money, time, bespoke engineering and exceptional effort. Responsible viability considers whether those resources are justified, repeatable and aligned with the value the concept is meant to create.

Appraisal frameworks such as the UK Green Book and Infrastructure Australia separate objectives, options, economics and delivery. RIBA places strategic definition and briefing before concept design. These are not retail concept models, but they expose the same weakness: a preferred expression should not acquire decision authority before purpose, constraints and evidence expectations are explicit. [S02-S04]

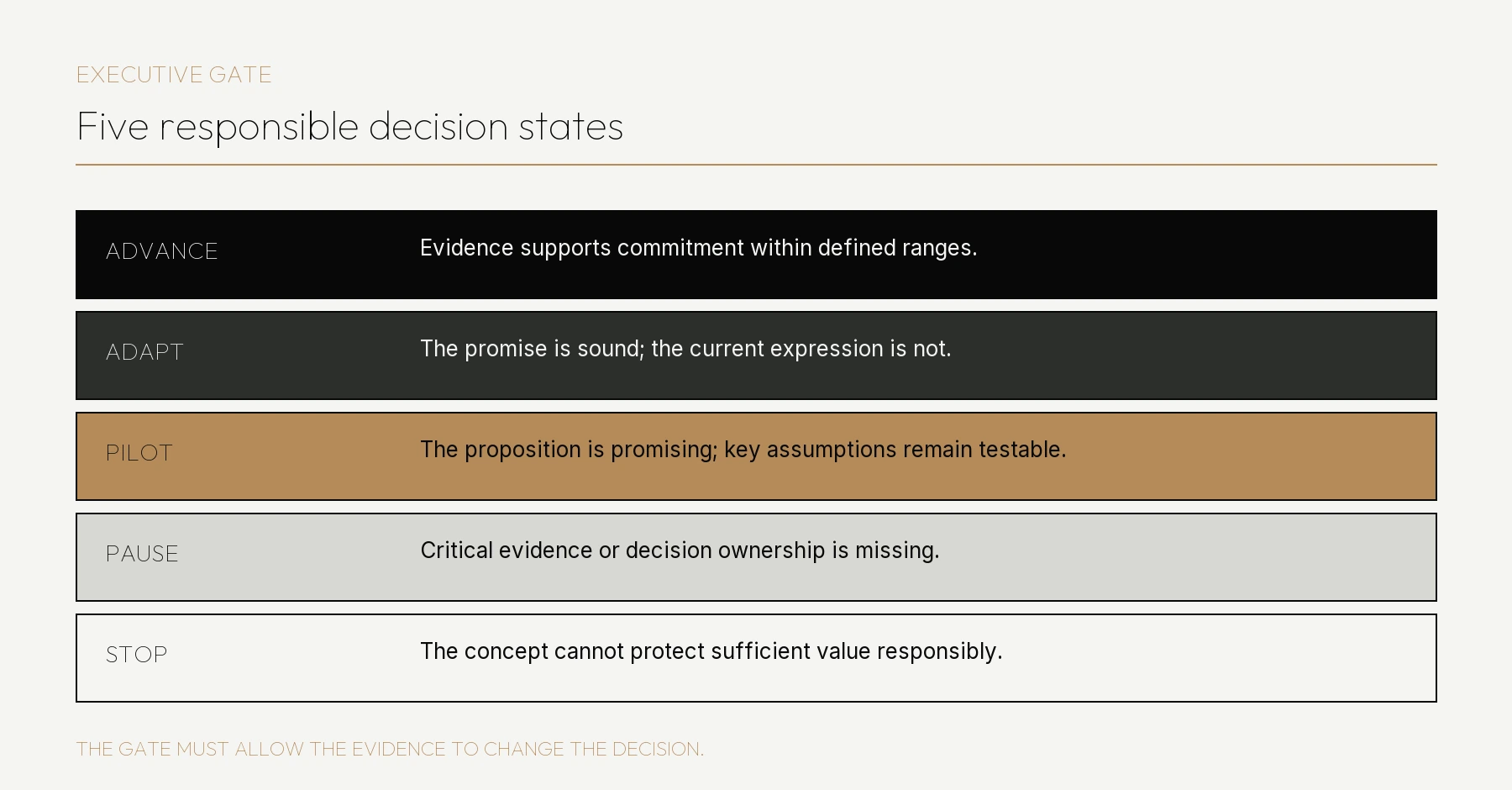

Five responsible decision states covering advance, adapt, pilot, pause and stop.
Figure 2. Five responsible viability decisions

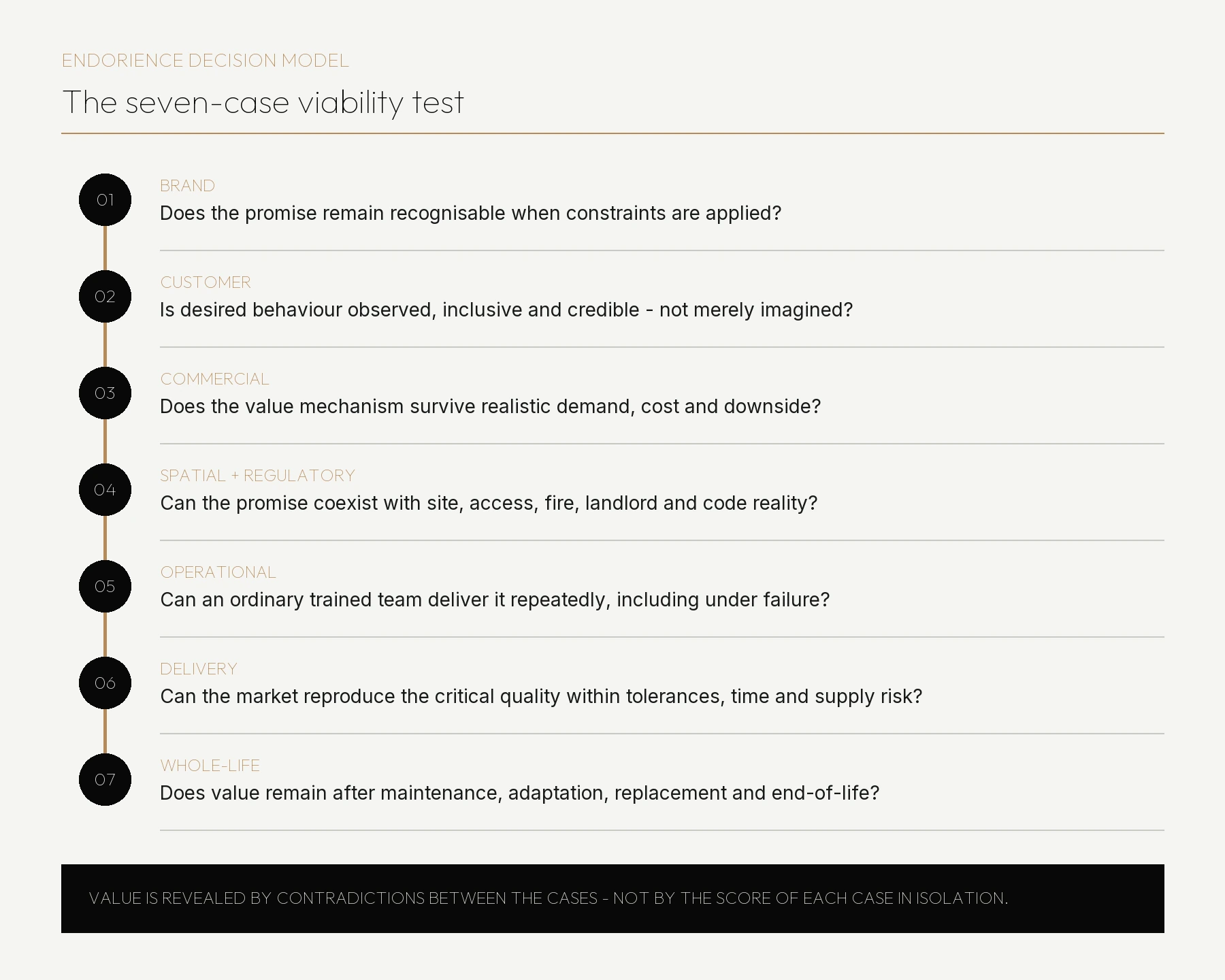

Seven cases, one proposition

Brand viability begins with the promise. What should customers understand, feel or be able to do because this environment exists? Which moments are essential, and which are only one possible expression? Without this distinction, the organisation cannot adapt intelligently when reality applies pressure.

Customer viability tests behaviour rather than internal enthusiasm. Who comes, what do they seek, where does friction arise and who may be excluded? Accessibility is not a late compliance line; it shapes the physical and digital journey. Evidence may come from observation, prototyping and service simulation, not only stated preference. [S07-S10, S21-S23]

Commercial viability makes the mechanism of value explicit. How should the concept influence demand, conversion, productivity, loyalty or portfolio value? What capital and operating consequences follow? What is the base case, and what happens if demand or adoption is lower than expected?

Spatial and regulatory viability recognises that every concept becomes site-specific before it becomes scalable. Structure, utilities, loading, acoustics, fire, access, heritage, landlord requirements and approvals can change the experience. Operational viability then asks whether an ordinary trained team can deliver the promise repeatedly - at opening, peak load, replenishment, failure and close.

Delivery viability tests whether the market can reproduce critical quality. Samples, tolerances, interfaces, lead times, logistics, installation, commissioning and replacement routes matter as much as design intent. Whole-life responsibility asks what remains after launch: durability, maintenance, energy, health, climate exposure, adaptability, repair and end-of-life. [S03, S05-S06, S11-S13]

The seven cases are not scores to be completed independently. Their value lies in the contradictions between them.

FROM ENDORIENCE PRACTICE

The living wall that could not live

In one retail project, living walls had become a central design idea and were extended across several parts of the interior. In drawings and visualisations they created the desired richness and vitality. The concept was persuasive because the finished image was easy to understand.

The actual environment could not support it. Light levels and humidity were unsuitable, and the maintenance conditions required by the planting had not shaped the design. The problem became undeniable only after the first walls were installed. The plants deteriorated and the smell of decaying vegetation entered the store experience.

We were able to stop the wider installation, but only after the first work and cost had been committed. The lesson was not that living walls are unsuitable for premium retail. It was that an attractive material idea had been approved without testing the environmental and operational conditions on which its viability depended.

Test before you promise

Evidence should be proportionate to novelty, uncertainty and reversibility. A familiar format in a known market may need targeted confirmation. An untested service model, new technology or bespoke material system needs deeper evidence before scale.

The instrument should match the question. An experience prototype reveals behaviour and exclusion. A technical mock-up tests quality, tolerances and maintenance. An operational simulation exposes staffing, timing and recovery. A supply-market test reveals capability and lead time. A reference-class view challenges internal optimism with comparable outcomes. A life-cycle hotspot review shows where value or environmental performance deteriorates over time. [S14-S15]

The critical principle is that a test must be able to change the decision. If a prototype exists only to demonstrate the sponsor's preferred answer, it is presentation theatre, not viability evidence.

Responsible ambition has more than two outcomes

Go/no-go framing forces teams to defend the whole concept or reject it. A more mature gate allows five responses. Advance when the cases support commitment within defined ranges. Adapt when the promise is sound but the current expression is weak. Pilot when important assumptions can be tested through bounded exposure. Pause when critical evidence or ownership is missing. Stop when the concept cannot protect sufficient value responsibly.

Stop is not the only sign that viability work has succeeded. A well-designed adaptation can protect the brand promise more effectively than literal fidelity to the first image. A pilot can prevent the portfolio from repeating an untested operating assumption. A pause can be the fastest route to a credible commitment.

The executive implication

Concept viability does not make premium ambition smaller. It prevents ambition from being consumed by avoidable compromise.

A viable concept is not one that survives a presentation. It is one that can survive reality and remain worth having.
